The apartment has been on the market as a grey shell and is not moving. Every viewer so far bought something finished instead. This brief defines the renovation that turns 63 m² of bare concrete into the apartment a buyer remembers on the drive home: a fully finished bathroom, a fully finished WC, a fitted kitchen. No furniture.
The developer still sells unsold stock in the same complex from around $1,900/m². A buyer looking at a grey shell has two options: ours at a 3% discount, or the developer's with a warranty, a payment plan and a sales office. That is not a discount, it is a rounding error. The resale shell has no argument to make.
Buyers in this segment are not construction managers. They cannot price the gap between bare concrete and a finished home, so they assume the worst and walk to the apartment where the gap is already closed. The three viewings that ended in someone else's renovated apartment are the market telling us exactly this.
The property is not selling at all. A finished apartment moves into a deeper, faster pool of buyers: relocators, families, and rental investors who want to move in or let it out this month.
Break-even sits near $2,350/m². Renovated stock in Krtsanisi trades from $2,300 to $2,800/m². The renovation pays for itself in the middle of that band and earns above it.
The delta between a forgettable beige renovation and a memorable one is a few thousand dollars of paint, tile and joinery choices. The price delta at the top of the comp band is five times that.
Not a taste exercise. Each rule exists to make the listing photos better or the viewing more convincing, and to keep money away from things buyers never notice.
The first three listing photos do most of the selling. That means the floor, the kitchen wall, the bathroom, and the light through the balcony doors. Concentrate budget on those four surfaces; everything else is competent and quiet.
Warm off-white walls throughout, with a single deep blue-green used deliberately, on kitchen fronts, or the WC, or a joinery wall. Colour is what makes a photo scroll-stopping. Colour everywhere is what makes it exhausting.
Oak-toned herringbone through the whole interior, no thresholds between rooms. In a 52 m² footprint, one continuous floor reads as a bigger apartment, and herringbone is the single cheapest signal of "this was designed".
Bathroom and WC done to the last towel rail, kitchen fitted with appliances. A half-finished wet room kills a deal faster than no renovation at all, because it reads as a problem the buyer inherits.
Fitted joinery, lighting, mirrors, blinds and door hardware are part of the build, not decoration. They carry the photographs without buying a sofa. Digital staging can add the rest for the listing.
Deep colour goes on repaintable surfaces. Tile, stone, worktops and floors stay in warm neutrals. A buyer who dislikes the blue can change it in a weekend, and knows it.
A handover-ready apartment: everything fixed to the building is finished and working. Nothing loose is bought.
Two grey areas to decide early, both cheap and both photographic: window blinds or curtain tracks, and a fitted bench or joinery wall in the living room. Treat them as scope, not decoration.
Twelve of those are on site. The four that decide whether the schedule holds are the first two and the last two: design lock and procurement at the front, photography and listing at the back.
Choose from the three scenarios, lock the layout, produce dimensioned plans, an electrical and lighting plan, and tile and joinery drawings. Every change after this week costs money and days.
Kitchen cabinetry, interior doors, tile, sanitaryware, appliances, flooring. Tile and doors are the usual schedule killers in Tbilisi. Order before demolition, not after.
Any partition changes, then electrical and plumbing first fix, bathroom waterproofing, floor levelling. Screed then needs its curing time. Do not compress it.
Bathroom and WC tiled, plasterboard ceilings built, walls skimmed. The apartment stops looking like a building site around week 8, which is a good moment for a site review.
Herringbone laid, skirting and cornice fixed, doors hung, kitchen installed and templated, painting. Worktop templating adds a week of its own if the top is stone.
Sanitaryware, taps, appliances, lighting, sockets, AC units, mirrors, towel rails. Commission the boiler and test every circuit and every drain.
Walk the apartment with a list, fix everything on it, then walk it again. Deep clean. This is the week people skip and regret.
Professional photographs in good afternoon light, a short walkthrough video, optional digital staging, then relist at the new price with a new headline. Treat it as a launch, not an edit to the old listing.
63 m² does not need a project management layer. It needs one person who answers questions the same day, and a contractor who does not need chasing.
| Role | Owns | Notes |
|---|---|---|
| Owner: Pavel | Budget, scenario choice, sale price, every trade-off between cost and finish | The single approval point. Same-day answers on site questions are worth more than a weekly site visit. |
| General contractor | All trades, sequencing, site protection, snagging | Fixed-price against a drawn scope. Ask for two references you can visit in person, and hold a retention until snagging closes. |
| Designer / visualiser | Layout, palette, lighting plan, tile and joinery drawings, renders | Can be a person or an AI-generated scenario pack refined into technical drawings. The drawings are the part that cannot be skipped. |
| Kitchen supplier | Survey, cabinetry, worktop template and install | Separate contract from the builder. Lead time drives the whole back half of the programme. |
| Site contact in Tbilisi | Deliveries, access, weekly photo report, cash payments | Essential if the owner is not in the country. A weekly ten-photo report catches most problems while they are still cheap. |
| Agent + photographer | Pricing sanity-check, listing, viewings, photo shoot | Bring the agent in at week 12, not week 16. A pricing opinion before the paint dries is still useful. |
| Complex | Krtsanisi Grande, Grande Group |
| Address | Krtsanisi Lane 17, Tbilisi 0114 |
| Status | Construction finished, unit delivered |
| Unit | 1-bedroom + living/kitchen, 2 balconies |
| Interior | 52.35 m² |
| Balconies | 4.24 + 6.48 = 10.72 m² |
| Total | 63.07 m² |
| Condition | Grey shell / white frame |
| Purchase | $1,600/m² · $100,800 |
| Held | ≈ 2.5 years |
Market figures cross-checked against Korter (Krtsanisi Grande), MyHome price-per-m² by district, Rinox renovation costs 2026 and PB Services renovation guide. Treat them as a band, not a quote. Confirm with a local agent before setting the sale price.

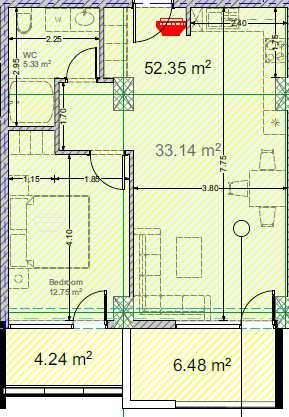

The plan is unusually good for its size: a 3.80 × 7.75 m living space with glazing at both ends, a genuine 12.75 m² bedroom, and the wet rooms stacked on one wall next to the entrance. The whole renovation is easier because the plumbing never has to travel.

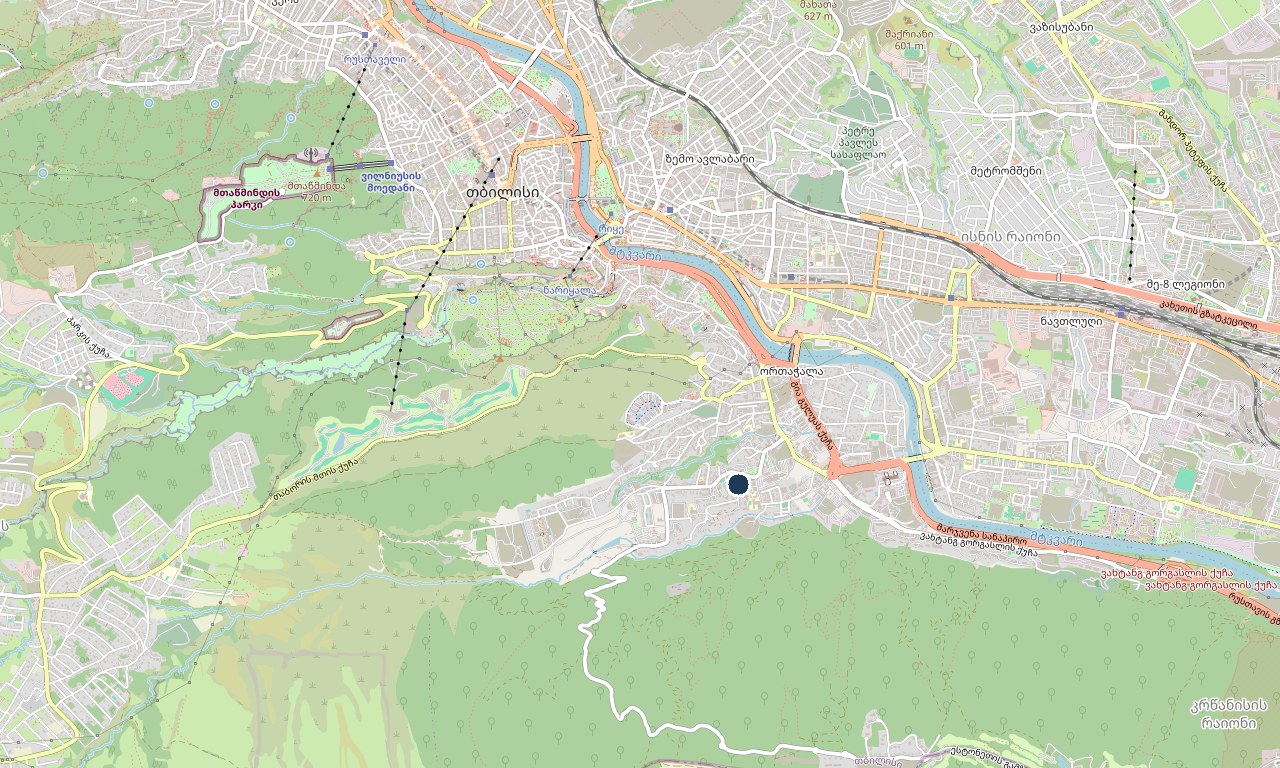

Krtsanisi sits along the Mtkvari south-east of the historic centre: government residence, embassy row, Krtsanisi Forest Park, and a corridor of new premium complexes. It is quiet in a way central Tbilisi is not, and still inside the city.
| Old Town / Meidan | ≈ 2.5 km · 5–10 min drive |
| Rustaveli Avenue | ≈ 4 km |
| Krtsanisi Forest Park | walking distance |
| Tbilisi International Airport | ≈ 20–30 min drive |
Outdoor and indoor pools, fitness and spa, three-level underground parking, 24/7 security and concierge, and roughly 10,000 m² of landscaped grounds with a playground. These are the amenities the listing should lead with. They justify a premium per m² that the apartment alone does not.
Relocated professionals and their families who want a finished home and a secure compound; Georgian buyers trading up from older stock; and investors buying for long-let, for whom "furnished-ready, tenant next month" is the whole pitch. All three want to see a finished kitchen and bathroom before they take the viewing seriously.
Collected without a brief, they converge hard: warm oak laid in herringbone, chalky off-white walls with proper white mouldings, and exactly one saturated colour, a deep blue that runs from navy to petrol teal, carried on joinery, doors and full walls. Brass where metal shows. Black used sparingly as a line, never a field.

Not Japandi, not Scandi, not the grey minimalism that fills every other listing in the district. A warm apartment with white mouldings, oak underfoot and one deep blue-green room. The look of a renovated Amsterdam or Paris flat, delivered with Turkish and Georgian materials.

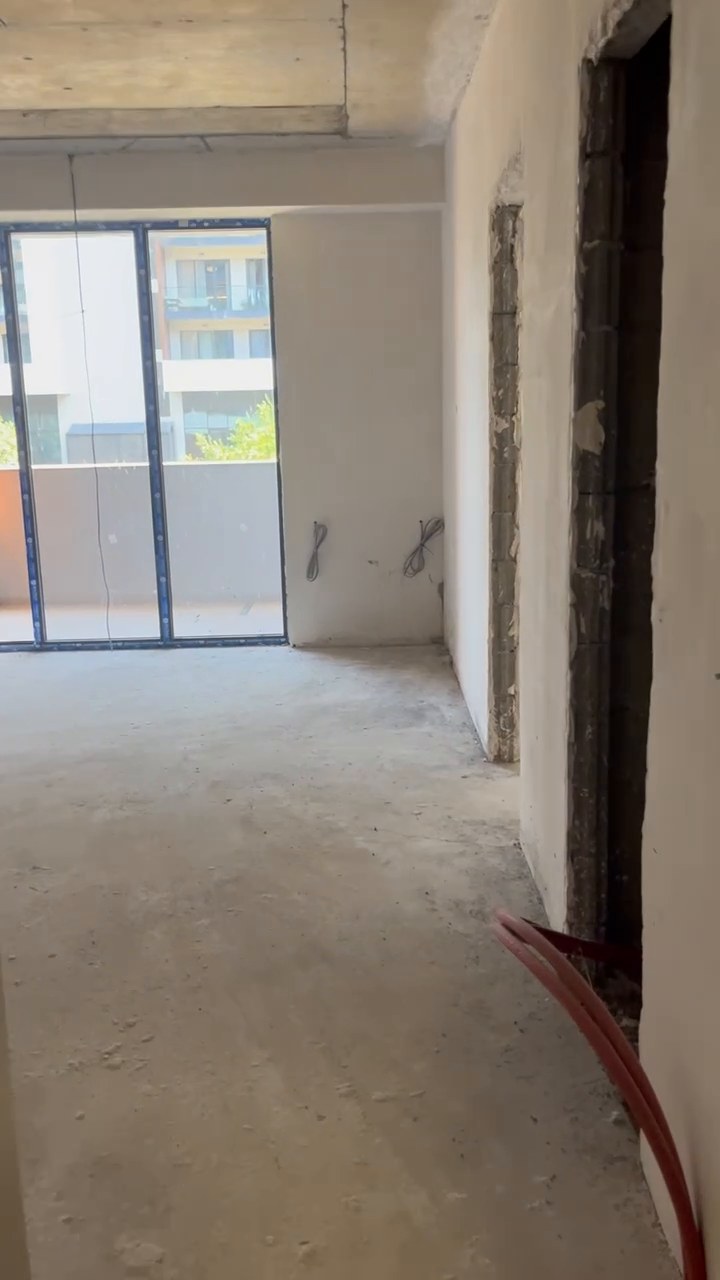

Better than the average white frame: glazing is in, services are terminated in a sensible place, and the balconies are already screeded and clad. Everything else starts from concrete.

26-second walkthrough: entrance, living room, balcony, utility corner and the view.

| Element | State today | Implication |
|---|---|---|

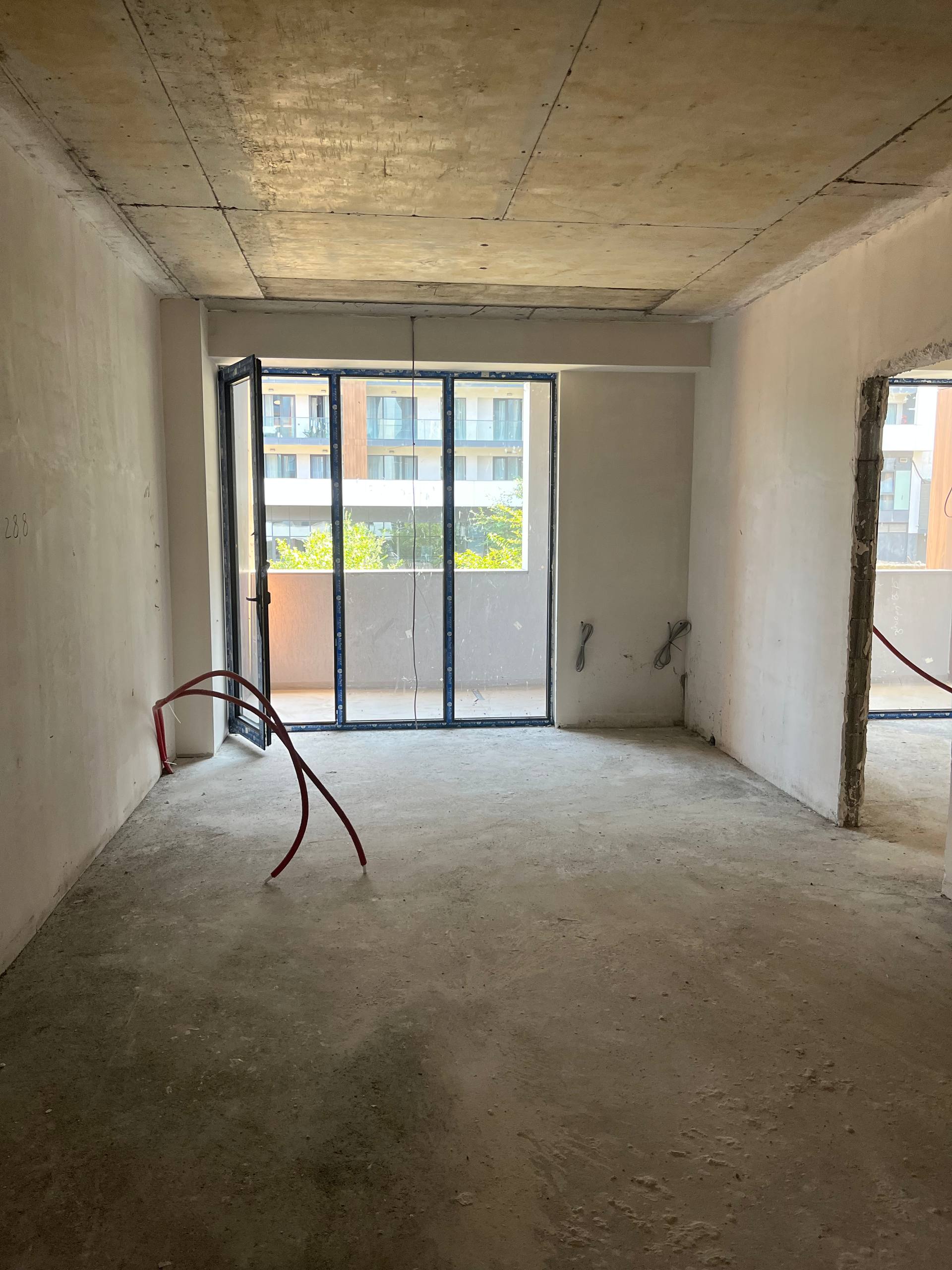

| Ceilings | Bare concrete slab, visible joints and formwork marks | Plasterboard ceiling throughout. Buys the coffer for downlights and hides the AC pipework. |
| Walls | Plastered, unpainted and patchy, some areas raw block | Skim coat and correction before paint. Budget for more correction than the photos suggest. |
| Floor | Raw concrete, no screed, uneven, pipe runs lying loose | Levelling screed across the full interior, with curing time in the programme. |

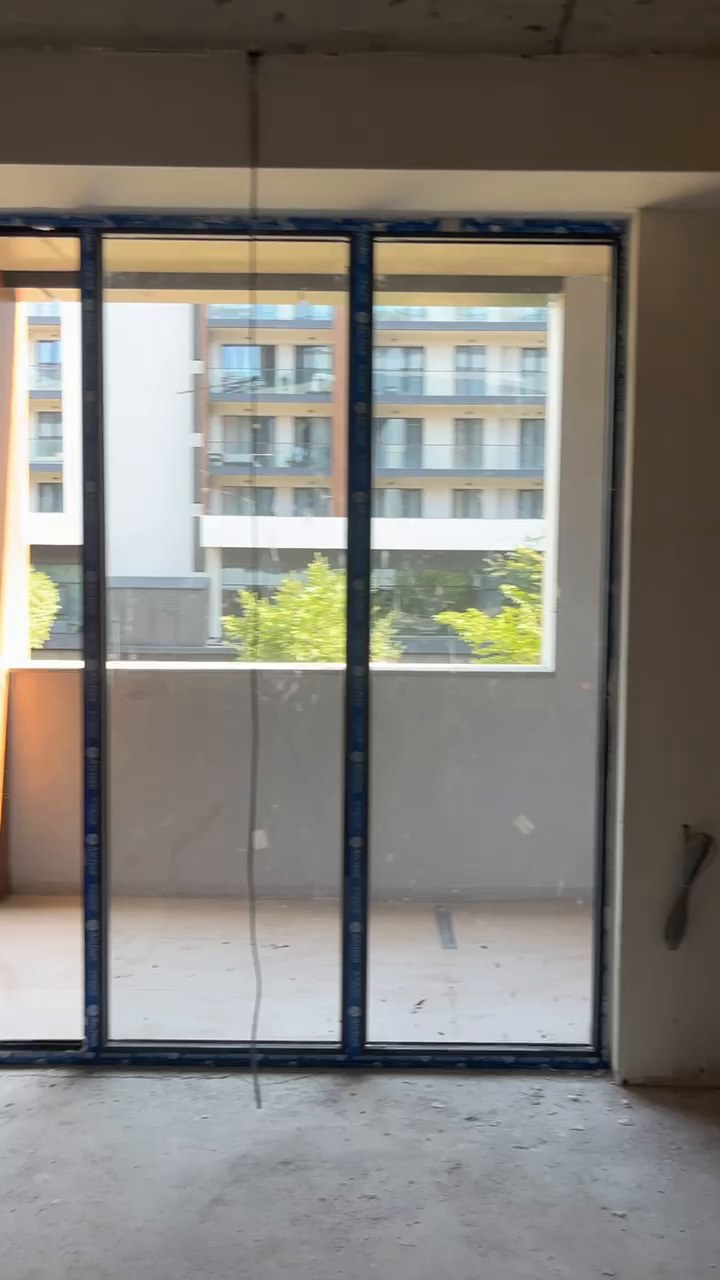

| Windows and balcony doors | Double glazed, aluminium/PVC, installed, film still on | Nothing to spend. Reveals need finishing and sills fitting. |

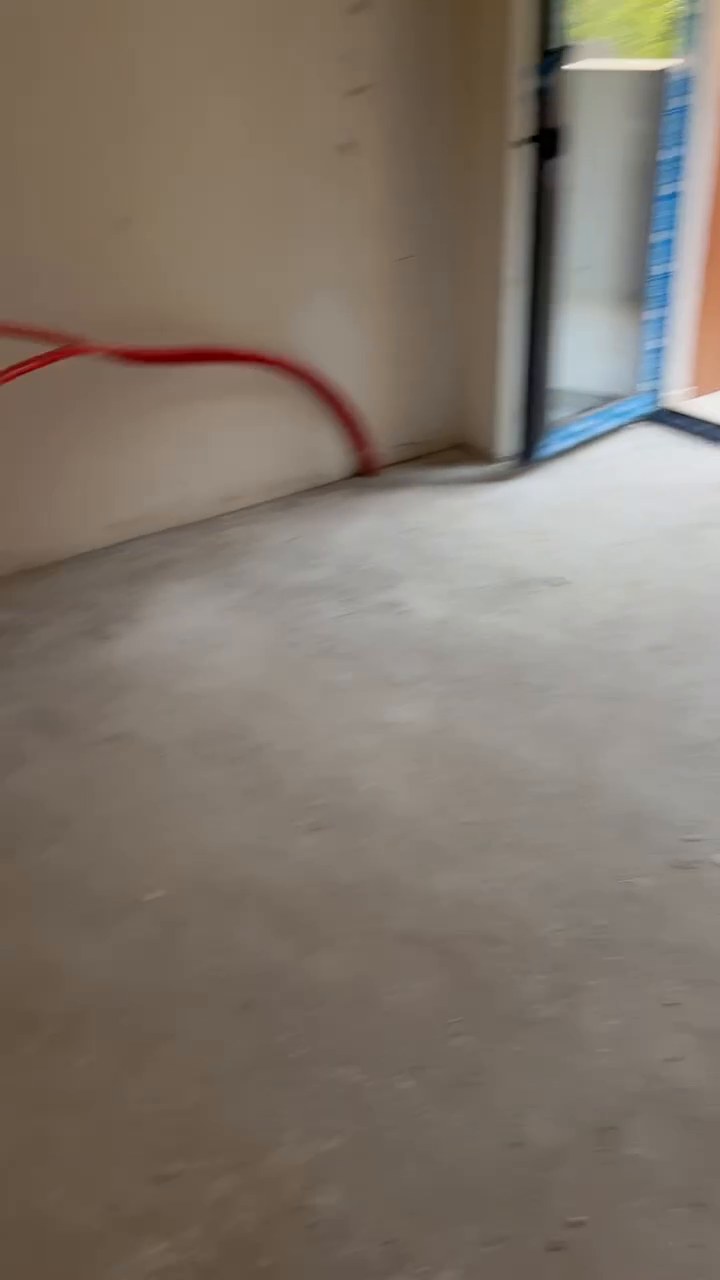

| Electrics | Cable tails stubbed out, no boxes, no consumer unit | Full first and second fix. Design the lighting before anything is chased. |

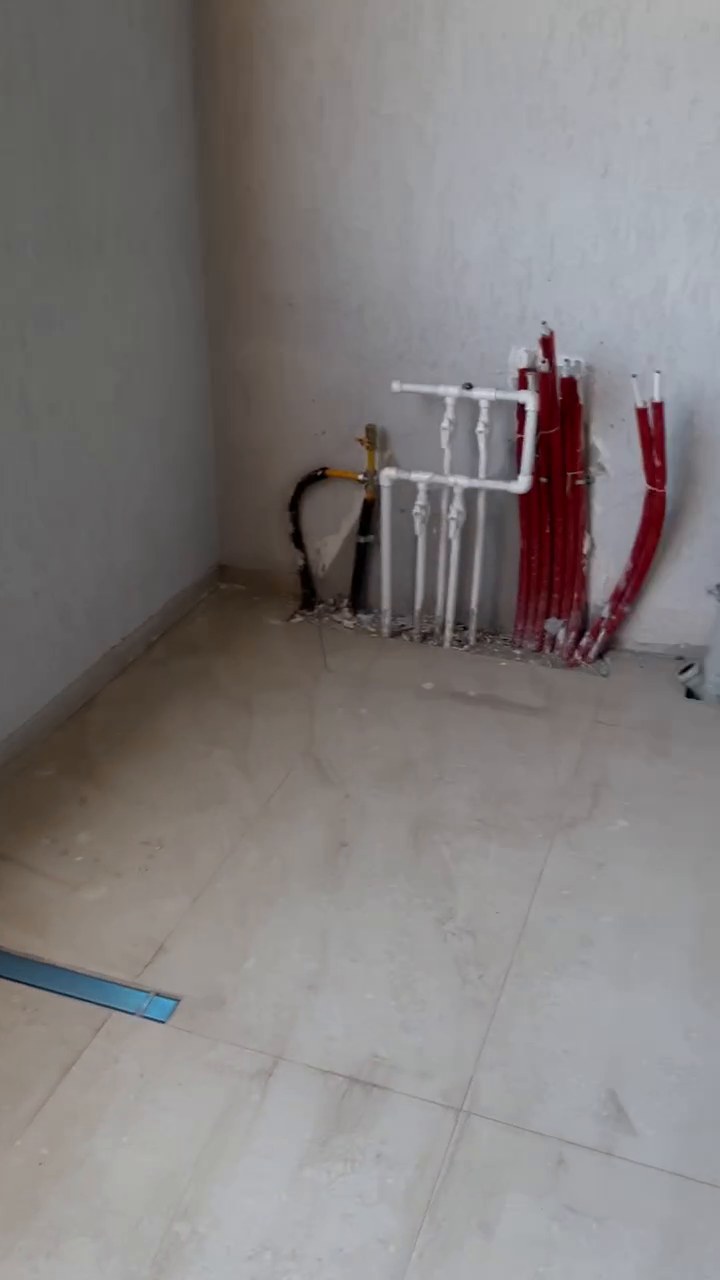

| Plumbing | Water manifold with valves and heating distribution terminated on the balcony | Good position. Runs to kitchen and wet rooms are short. Boil down to one clean chase. |
| Gas | Gas line present at the balcony utility corner | Boiler location is effectively decided. Box it in, ventilate it, keep access. |
| Heating and cooling | None installed | Radiators or underfloor, plus two split AC units. Underfloor competes with floor build-up. Decide at design lock. |

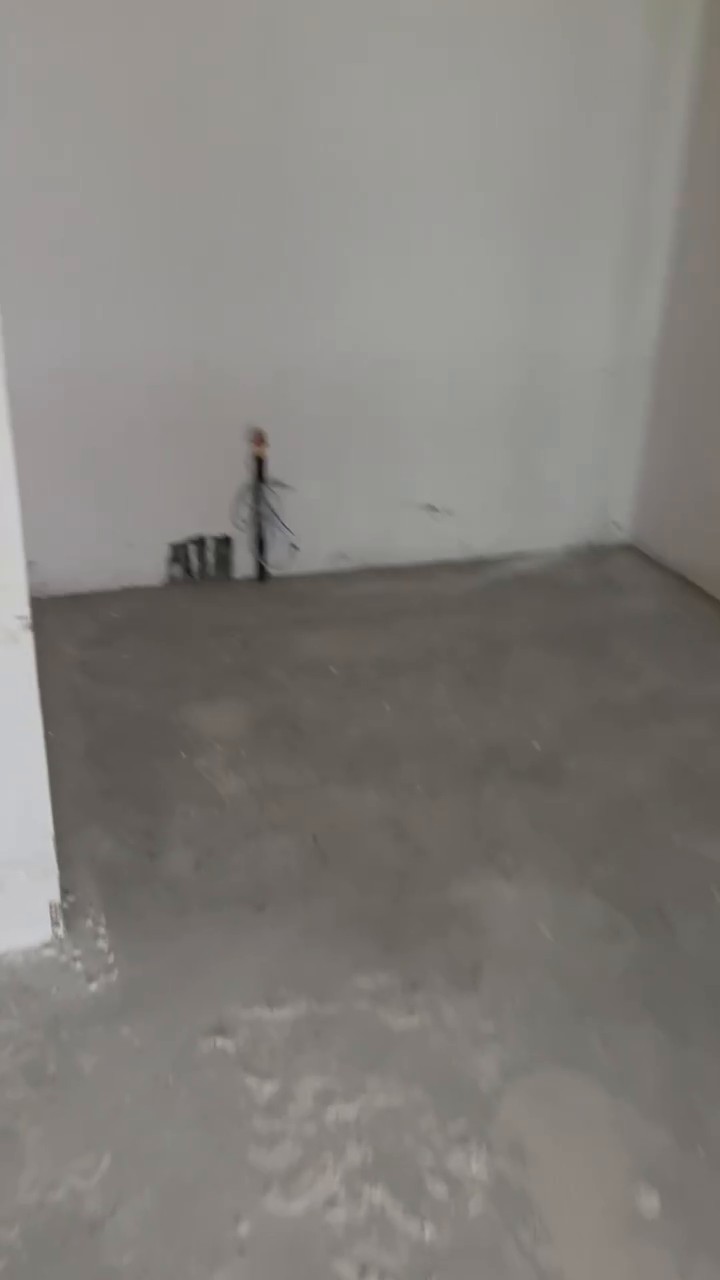

| Wet rooms | Empty shell, no waterproofing, no fixtures | Full build: tank, tile, fit out. The single biggest line item after the kitchen. |
| Kitchen | Nothing | Full fitted kitchen with appliances. Longest lead time on the job. |
| Doors | No interior doors; entrance door basic | Three interior doors plus an entrance door upgrade. Cheap, and buyers touch every one of them. |

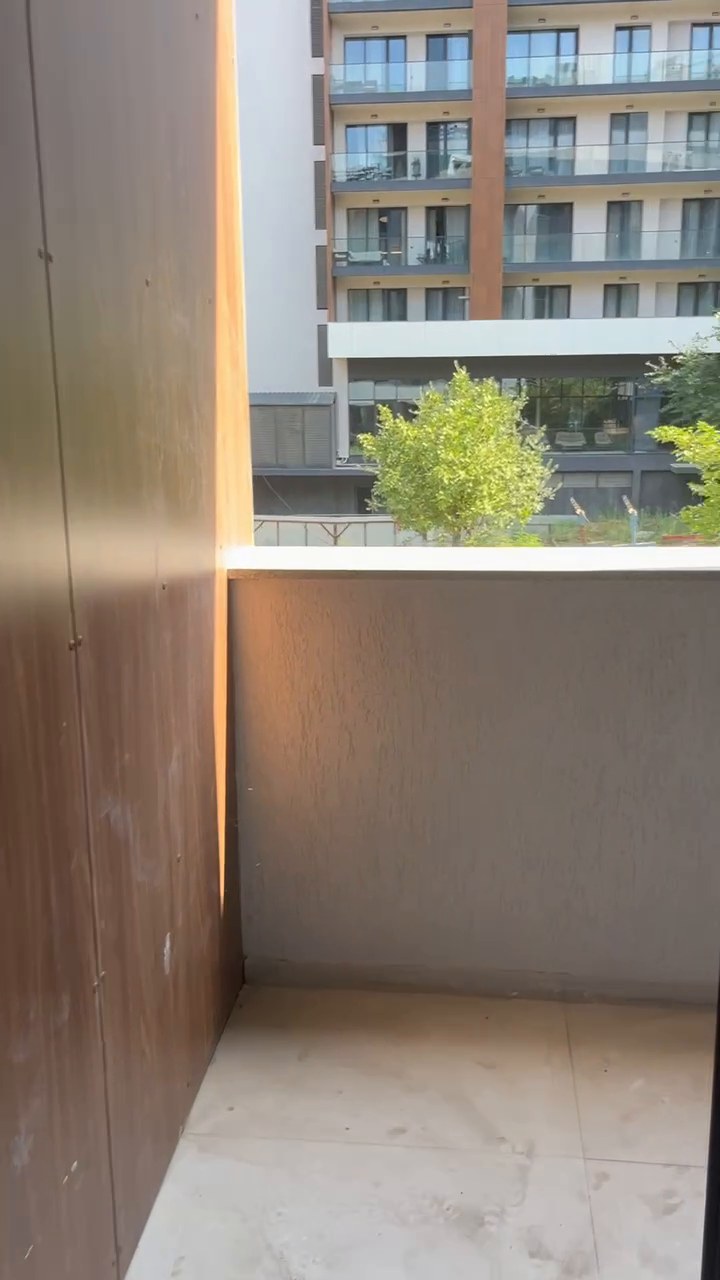

| Balconies | Floors finished, reveals clad, drain present | Light touch only: clean up, lighting, one socket, screen the utility corner. |
Grouped by phase. Critical path items are the ones that push the finish date if they slip. Nothing below assumes a specific scenario. The scenarios change the finishes, not the sequence.
| # | Task | Phase | Flag |
|---|---|---|---|
| 1 | Measure the apartment properly: dimensions, ceiling height, floor level variance, service positions | Design | Critical path |
| 2 | Choose one of the three renovation scenarios and freeze it | Design | Critical path |
| 3 | Produce dimensioned layout, electrical and lighting plan, tile setting-out, joinery drawings | Design | Critical path |
| 4 | Confirm target sale price with an agent against live renovated comps | Design | |
| 5 | Tender the scope to three contractors, fixed price, same drawings | Procurement | Critical path |
| 6 | Sign contract with payment schedule tied to milestones and a retention | Procurement | |
| 7 | Order kitchen cabinetry and worktop, survey first | Procurement | Critical path |
| 8 | Order tile, sanitaryware, taps and shower set | Procurement | Critical path |
| 9 | Order interior doors and entrance door | Procurement | Critical path |
| 10 | Order flooring, skirting and cornice with 10% waste allowance | Procurement | |
| 11 | Order appliances: hob, oven, hood, fridge, dishwasher, washing machine | Procurement | |
| 12 | Register works with the building management, agree lift access and working hours | Procurement | |
| 13 | Site protection: glazing, entrance door, balcony finishes, lift | Rough works | |
| 14 | Build or adjust partitions per the chosen layout | Rough works | Critical path |
| 15 | Electrical first fix: chases, consumer unit position, all circuits, lighting points, data | Rough works | Critical path |
| 16 | Plumbing first fix: hot, cold and drainage to kitchen, bathroom, WC, washing machine | Rough works | Critical path |
| 17 | Heating: boiler position and flue, radiator or underfloor loops from the balcony manifold | Rough works | Critical path |
| 18 | AC first fix: indoor unit positions, condensate runs, outdoor unit mounting | Rough works | |
| 19 | Bathroom and WC tanking: full waterproofing to floor and wet walls, flood test | Rough works | Critical path |
| 20 | Levelling screed across the full interior, then cure | Rough works | Critical path |
| 21 | Tile bathroom and WC: floor and walls, setting-out approved on site before adhesive | Surfaces | Critical path |
| 22 | Plasterboard ceilings with service voids and AC access panels | Surfaces | |
| 23 | Wall correction and skim, window reveals, sills | Surfaces | |
| 24 | Kitchen splashback and any feature wall tiling | Surfaces | |
| 25 | Lay herringbone flooring wall to wall, no thresholds between rooms | Fit-out | Critical path |
| 26 | Fix skirting and cornice, fill and caulk every joint | Fit-out | |
| 27 | Hang interior doors, fit entrance door and all hardware | Fit-out | |
| 28 | Install kitchen cabinetry; template worktop and install once cut | Fit-out | Critical path |
| 29 | Build any fitted joinery: niche unit, bench, wardrobe carcass | Fit-out | Optional |
| 30 | Paint everything: ceilings, walls, trim, accent colour | Fit-out | |
| 31 | Sanitaryware, taps, shower screen, towel rails, mirrors, bathroom accessories | Second fix | |
| 32 | Appliances installed, plumbed and tested | Second fix | |
| 33 | Electrical second fix: sockets, switches, all light fittings, extract fans | Second fix | |
| 34 | AC units mounted and commissioned; boiler commissioned and certified | Second fix | |
| 35 | Blinds or curtain tracks fitted | Second fix | Optional |
| 36 | Balcony finishing: clean up, box in and ventilate the utility corner, add light and socket | Second fix | |
| 37 | Snagging walk with a written list; fix; second walk to close it | Handover | Critical path |
| 38 | Deep clean including glazing, balconies and inside every cabinet | Handover | |
| 39 | Collect warranties, appliance manuals, boiler certificate, paint codes for the buyer | Handover | |
| 40 | Professional photography and a walkthrough video, shot in afternoon light | Go to market | Critical path |
| 41 | Digital staging of the empty rooms for the listing | Go to market | Optional |
| 42 | Relist as a new launch: new price, new headline, new photo set, agent briefed | Go to market | Critical path |
Illustrative, not a quote. The point is the shape of the trade, not the third decimal place. Confirm every line against a real Tbilisi tender before committing.
| Line | Low | High |
|---|---|---|
| Design, drawings, site setup | $900 | $1,800 |
| Partitions, plaster correction, screed | $2,500 | $3,500 |
| Electrics, first and second fix | $2,200 | $3,200 |
| Plumbing and heating | $2,400 | $3,600 |
| Split AC, two units | $1,100 | $1,900 |
| Bathroom + WC, complete | $4,500 | $6,800 |
| Kitchen with appliances | $5,000 | $8,000 |
| Flooring, skirting, cornice | $2,300 | $3,800 |
| Doors and hardware | $1,200 | $2,100 |
| Ceilings, painting, decoration | $2,000 | $3,000 |
| Lighting and electrical fittings | $900 | $1,700 |
| Balconies, clean, snagging | $800 | $1,400 |
| Contingency, 10% | $2,600 | $4,100 |
| Total | $28,400 | $44,900 |
| Per m² of total area | $451 | $712 |
Plan around $32,000. Below $28k the finish stops being the reason someone pays a premium; above $40k the maths only works at the top of the comp band.
| Scenario | $/m² | Sale | vs. today's ask |
|---|---|---|---|
| Do nothing (current ask) | 1,840 | $115,920 | n/a |
| Break-even after $32k | 2,348 | $147,920 | $0 |
| Conservative | 2,400 | $151,200 | +$3,280 |
| Mid-band | 2,550 | $160,650 | +$12,730 |
| Top of band | 2,750 | $173,250 | +$25,330 |
All figures on 63.07 m² total area, $32,000 renovation, before agency fees and taxes. If local comps are quoted on interior area only, the totals hold but the per-m² numbers shift up by ~20%.
The repository contains a prompt that turns this brief into three fully specified renovation scenarios: layout, palette, materials, kitchen and bathroom specification, budget and the argument each one makes to a buyer. Run it, compare them side by side, choose one, and freeze it in week two.
